How An Engine Radiator Works And What A Remote Radiator Is

Knowledge base

In short

An engine radiator takes the heat from the engine coolant and releases it to the air so that the coolant can circulate again. It can be mounted on the engine, or it can stand away from the engine as a remote radiator with its own electric fans. The site and the installation decide which kind fits.

An engine turns only part of its fuel into shaft power. Much of the rest leaves with the exhaust, and a large share goes into the coolant: the water-glycol mixture that circulates through the cylinder jackets, the charge-air cooler and often the oil cooler. The radiator is where that coolant gives its heat to the air so that it can go round again, and on the hottest day of the year at full load it still has to keep the engine inside its maker's temperature limits.

This guide explains the circuits, the two kinds of radiator - engine-mounted and remote - and what decides between them.

The Cooling Circuits Of A Modern Engine

Smaller engines have one circuit: the pump pushes coolant through the engine, out to the radiator and back, with a thermostat holding the temperature. Larger engines have two. The high-temperature (HT) circuit cools the cylinder jackets and the first stage of the charge-air cooler. The low-temperature (LT) circuit cools the second charge-air stage and the oil, and must return to the engine cool, because the engine's rating and its emissions depend on cool, dense intake air.

An LT/HT radiator puts both circuits into one unit under one row of fans. Each circuit has its own flow, its own temperatures and its own limit on external pressure drop from the engine maker, and the radiator is designed to all of them at once.

The Engine-Mounted Radiator

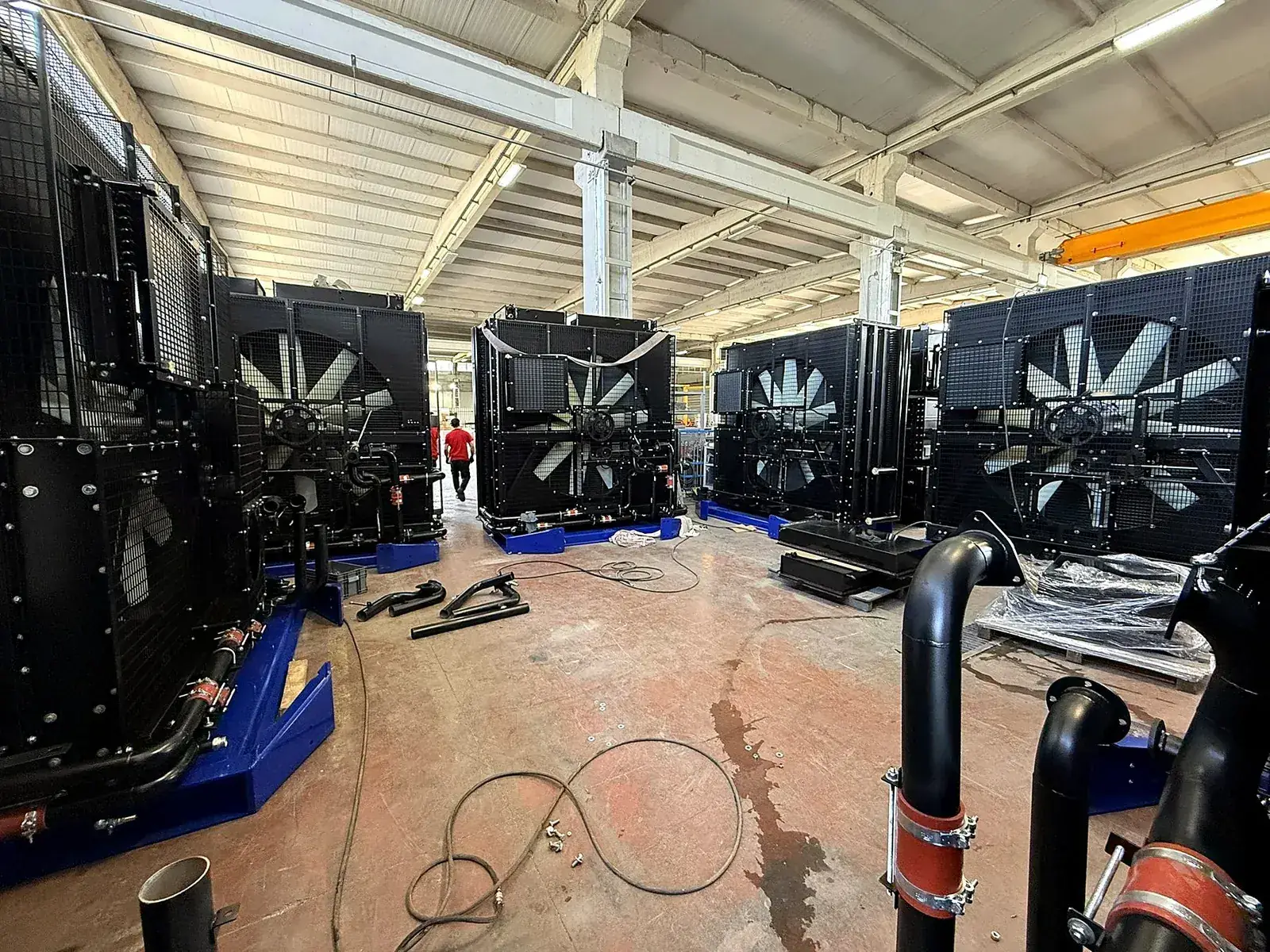

The classic generator-set radiator stands on the skid in front of the engine, and its fan is driven by the engine through a belt or a shaft: a mechanical driven radiator. It is self-contained - no electric fan power, no control panel, no pipework - and it is the engine maker's standard package for an open plant room or an outdoor canopy. Its fan takes a share of the engine's output, turns whenever the engine turns, and draws its air through the engine room.

That last point is its limit. In a closed room the inlet opening, the discharge duct and the attenuators must all be made for the full airflow of the fan, the room gets warm, and the fan runs at one speed and one sound level. TECS builds mechanical driven radiators as complete vertical packages matched to the engine; where the room, the heat or the noise argue against them, the remote radiator takes over.

The Remote Radiator

A remote radiator stands apart from the engine - outside the building, on the roof, on a platform - and has its own electric fans. The coolant reaches it through pipework; the engine room only has to ventilate the heat radiated by the engine and the alternator. The fans take their power from the auxiliary supply and, with EC motors or a frequency converter, run only as fast as the coolant temperature asks: on a cool day or at part load the fan power and the sound level fall sharply.

It is the same machine the HVAC world calls a dry cooler, designed to the engine maker's data. Horizontal with the fans on top where there is ground, vertical against a louvre where the air is ducted, V-type where many units must share a small plot. Hot, high, dusty or coastal sites change its size and its materials, not its principle; a sound limit at the fence is met by the choice of fans and the length of the unit.

Choosing Between The Two

Open skid, no sound limit, standby duty: the engine-mounted radiator is the simpler and cheaper package. Engine in a building or a container, a noise-sensitive site, several sets side by side, prime or continuous power, a hot engine room: the remote radiator. Many generator-set builders offer both and let the installation decide; TECS designs and builds both, to the same engine data sheet.

For a proposal, send the engine make and model with its cooling data sheet, the site ambient and altitude, where the set will stand and any sound limit - or send the drawings and the data sheets through the file transfer page.

In Short

  • The coolant carries a large share of the fuel energy to the radiator
  • Large engines have an HT circuit for the jackets and an LT circuit for the charge air and oil
  • Engine-mounted radiator: belt-driven fan on the skid, air through the engine room
  • Remote radiator: electric fans, stands apart, air from outside, speed control
  • Each circuit has its own flow, temperature and pressure drop limit from the engine maker
  • TECS builds both kinds, single circuit or LT/HT, for any engine make
See the products

To Have A Radiator Designed

  • Engine make, model and rating with the cooling data sheet
  • Heat rejection, flow and temperatures per circuit, if the data sheet is not at hand
  • Coolant mixture and percentage
  • Site ambient, humidity and altitude
  • Where the set stands and where the radiator could stand
  • Sound limit and distance, power supply for the fans
Send an enquiry Send us files

Questions We Are Often Asked

What is a remote radiator?

An air-cooled radiator with its own electric fans that stands away from the engine. The coolant is pumped to it through pipework and returns after giving up its heat to the air. The HVAC term for the same unit is dry cooler.

What does LT/HT mean?

Low temperature and high temperature: the two cooling circuits of a modern engine. HT cools the cylinders, LT cools the charge air and the oil. An LT/HT radiator carries both in one casing.

Why does the engine maker limit the pressure drop?

The engine's own pump has a fixed head. If the radiator and the pipework take more of it than the maker allows, the flow through the engine falls, the engine runs hot and may shut down on a hot day.

How far can the radiator be from the engine?

Quite far; the distance is set by the pipework and the engine maker's limit. Longer runs need larger pipes or a booster pump, and TECS Engineering takes the distance into account in the proposal.

Can one radiator serve several engines?

Usually each engine has its own radiator, so that one engine's cooling does not depend on another's. A common cooling circuit with a bank of radiators is used in some plants and needs its own pumps and controls.
